Cultivera Insights 01 National policy paper / June 2026

From installation to sustained value.

A national policy paper for biogas, Bio-CNG and circular agriculture in Bangladesh.

Recommendation: finance retained use, service and productive value, not installation alone.

Length
15 pages
Geography
Bangladesh
Audience
Policy, finance and delivery

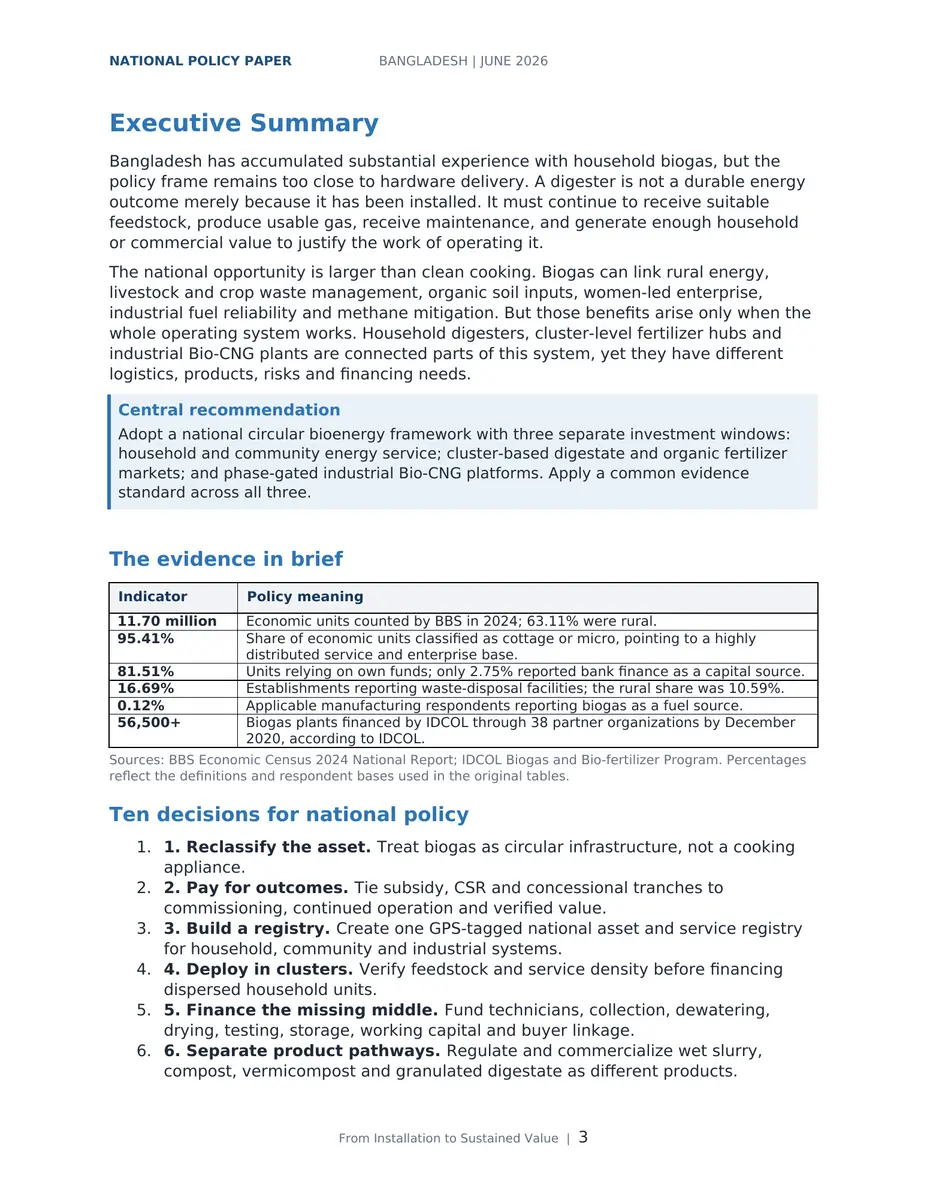

Cover of From Installation to Sustained Value

Change what finance requires.

Five changes move the focus from installation to continued performance.

Begin with the installed base

Audit before expanding.

Reconcile existing assets and establish functionality, retained use, service cost and household value. Performance needs records beyond installation totals.

Minimum record Persistent asset ID, owner, installer, commissioning, service history and 6-, 12- and 24-month status.

One published baseline. Three proposal figures.

68,000+

IDCOL-financed plants

Published programme figure reported by December 2023.

3

business models

Proposed policy structure, not a current programme count.

36

months

Proposed implementation sequence, not reported delivery.

6 · 12 · 24

month checks

Proposed status points for the installed-asset record.

Source: IDCOL biogas programme reporting for the published plant figure. All other figures in this strip are policy proposals.

Finance each model differently.

Each model has a different service, revenue route and scale gate.

Household and community

Energy service

Finance verified eligibility, commissioning, local after-sales service and retained use.

Scale gateFunctioning and used at 12 months
Cluster level

Circular agriculture hubs

Fund collection, processing, quality checks, storage, working capital and buyer linkage.

Scale gateValidated product and recurring buyers
Industrial

Bio-CNG and fertiliser

Begin with a smaller module and prove feedstock, gas quality, uptime and both markets.

Scale gateStable operation and binding offtake

Four phases. Four gates.

Months 0–6

Build the base

Set governance, reconcile assets, publish standards and map feedstock, service and buyers.

Gate: verified baseline
Months 7–18

Run controlled phases

Deploy household clusters, circular hubs and a smaller industrial module under one record standard.

Gate: operating stability
Months 19–30

Evaluate independently

Validate retention, operating records, service quality, product absorption, inclusion, safety and methane performance.

Gate: credible operating proof
Months 31–36

Scale selectively

Expand only the models that clear agreed thresholds and publish standard contracts and results.

Gate: replication decision

What is sourced and what is proposed.

The paper combines published data, project material and assumptions. Site decisions still require feasibility work.

Published source Official or public reference Project material Attribution subject to confirmation Model assumption Used before operating results exist

Project and Bio-CNG figures require partner checks before attribution or investment use.

Move from installed assets to lasting value.
